Quarterly Schedules

HRERA Panchkula
Project Registration Number : HRERA-PKL-FBD-130-2019
Project Name : OMAXE CITY
Project Number : RERA-PKL-575-2019
Project Type : NEW
S.No.ParticularsAmount
(In Lakhs)
1Cost of the land (if included in the estimated cost)393
2Estimated cost of construction of apartments0
3Estimated cost of infrastructure & other structure820
4Other cost including EDC taxes, levies, etc2003.48
Total3216.79
Total Expenditure on the project820.32
Expenditure made upto the date of Registration0



EDC due as on the date of Registration1374.5

;
S.No.Cash InflowAmount
(In Lakhs)
1Opening Balance0
2Amount collected from allottees against booked plots and/or apartments720.42
3Amount availed from the bank/financial institutions0
4Amount contributed by the promoters/his associates0
5Any other receipt0
Total720.42



S.No.Cash OutflowAmount
(In Lakhs)
1Expenditure on construction of apartments0
2Expenditure on infrastructure & other structure12.57
3Other costs including EDC, taxes, etc257.73
Total270.3
Balance450.12



S.No.Information relating to Escrow AccountAmount
(In Lakhs)
1Opening balance at the beginning of the quarter0
2Amount deposited in Escrow Account360.97
3Amount withdrawn during the quarter360.97
4Balance at the end of the quarter0
Total Plots in the colony242
Plots sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1PLOTS73



Total Apartments in the colony0
Apartments sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1NA0



Total Garages in the colony0
Garages sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1NA0



S.No.Expenditure on Infrastructure made in the QuarterAmount
(In Lakhs)
1Infrastructure12.57
2Apartments0
3EDC, IDC, etc257.73
4Others Expenditure0



S.No.Expenditure on Taxes,Levies,EDC etc in the QuarterAmount
(In Lakhs)
1Actual paid as on date257.73
2EDC due as on date1116.77
Sr. No.Document DescriptionDate of Upload Document View
1 A SEPARATE CERTIFICATE BY A CHARTERED ACCOUNTANT CERTIFYING THE TOTAL CUMULATIVE COST INCURRED ON CONSTRUCTION OF THE PROJECT UPTO END OF LAST QUARTER; THE PERCENTAGE OF REMAINING WORK IN TERMS OF COST, AND THE ESTIMATED BALANCE COST TO BE INCURRED FOR COMPLETION OF THE PROJECT. 17-01-2020  View
2 SELF CERTIFICATE OF THE PROMOTER TO SHOW THE NUMBER OF PLOTS/APARTMENTS SOLD UPTO THE DATE OF REGISTRATION AND THE PLOTS/APARTMENTS SOLD IN EACH QUARTER THERE-AFTER. 17-01-2020  View
3 CERTIFICATE OF THE REGISTERED ARCHITECT OF THE PROJECT CERTIFYING THE PERCENTAGE OF THE CONSTRUCTION WORK UPTO DATE; THE PERCENTAGE OF CONSTRUCTION WORK UNDERTAKEN DURING THE PREVIOUS QUARTER; AND THE PERCENTAGE OF WORK REMAINING. 17-01-2020  View
4 A CERTIFICATE OF THE REGISTERED ENGINEER CERTIFYING PERCENTAGE OF INFRASTRUCTURE WORK CARRIED OUT. THE INFRASTRUCTURE WORK INCLUDES ROADS, SEWERAGE SYSTEM, STORM WATER DRAINAGE SYSTEM, WATER SUPPLY, AND ELECTRICITY SUPPLY. 17-01-2020  View
5 CERTIFICATE OF CHARTERED ACCOUNTANT OF THE PROJECT TO SHOW TOTAL AMOUNT OF MONEY RECEIVED FROM ALLOTTEES AND OTHER SOURCES; MONEY DEPOSITED IN THE ESCROW ACCOUNT; THE MONEY WITHDRAWN FROM THE ESCROW ACCOUNT; AMOUNT OF FUNDS INVESTED ON THE CONSTRUCTION WORK OF THE PROJECT INCLUDING PURCHASE OF MATERIALS. THE CERTIFICATE SHALL ALSO CONTAIN INFORMATION RELATING TO THE QUANTUM OF MONEY WITHDRAWN BY THE PROMOTERS FOR THE PURPOSES OTHER THAN FOR THE PROJECT 17-01-2020  View

;
S.No.Cash InflowAmount
(In Lakhs)
1Opening Balance450.12
2Amount collected from allottees against booked plots and/or apartments16.03
3Amount availed from the bank/financial institutions0
4Amount contributed by the promoters/his associates0
5Any other receipt0
Total16.03



S.No.Cash OutflowAmount
(In Lakhs)
1Expenditure on construction of apartments9.85
2Expenditure on infrastructure & other structure0
3Other costs including EDC, taxes, etc0
Total0
Balance0



S.No.Information relating to Escrow AccountAmount
(In Lakhs)
1Opening balance at the beginning of the quarter0
2Amount deposited in Escrow Account16.03
3Amount withdrawn during the quarter16.03
4Balance at the end of the quarter0
Total Plots in the colony242
Plots sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1PLOTS4



S.No.Expenditure on Infrastructure made in the QuarterAmount
(In Lakhs)
1Infrastructure150
2Apartments0
3EDC, IDC, etc0
4Others Expenditure0



S.No.Expenditure on Taxes,Levies,EDC etc in the QuarterAmount
(In Lakhs)
1Actual paid as on date0
2EDC due as on date0
Sr. No.Document DescriptionDate of Upload Document View
1 CERTIFICATE OF CHARTERED ACCOUNTANT OF THE PROJECT TO SHOW TOTAL AMOUNT OF MONEY RECEIVED FROM ALLOTTEES AND OTHER SOURCES; MONEY DEPOSITED IN THE ESCROW ACCOUNT; THE MONEY WITHDRAWN FROM THE ESCROW ACCOUNT; AMOUNT OF FUNDS INVESTED ON THE CONSTRUCTION WORK OF THE PROJECT INCLUDING PURCHASE OF MATERIALS. THE CERTIFICATE SHALL ALSO CONTAIN INFORMATION RELATING TO THE QUANTUM OF MONEY WITHDRAWN BY THE PROMOTERS FOR THE PURPOSES OTHER THAN FOR THE PROJECT 19-02-2021  View
2 A SEPARATE CERTIFICATE BY A CHARTERED ACCOUNTANT CERTIFYING THE TOTAL CUMULATIVE COST INCURRED ON CONSTRUCTION OF THE PROJECT UPTO END OF LAST QUARTER; THE PERCENTAGE OF REMAINING WORK IN TERMS OF COST, AND THE ESTIMATED BALANCE COST TO BE INCURRED FOR COMPLETION OF THE PROJECT. 19-02-2021  View
3 A CERTIFICATE OF THE REGISTERED ENGINEER CERTIFYING PERCENTAGE OF INFRASTRUCTURE WORK CARRIED OUT. THE INFRASTRUCTURE WORK INCLUDES ROADS, SEWERAGE SYSTEM, STORM WATER DRAINAGE SYSTEM, WATER SUPPLY, AND ELECTRICITY SUPPLY. 19-02-2021  View
4 CERTIFICATE OF THE REGISTERED ARCHITECT OF THE PROJECT CERTIFYING THE PERCENTAGE OF THE CONSTRUCTION WORK UPTO DATE; THE PERCENTAGE OF CONSTRUCTION WORK UNDERTAKEN DURING THE PREVIOUS QUARTER; AND THE PERCENTAGE OF WORK REMAINING. 15-03-2021  View
5 SELF CERTIFICATE OF THE PROMOTER TO SHOW THE NUMBER OF PLOTS/APARTMENTS SOLD UPTO THE DATE OF REGISTRATION AND THE PLOTS/APARTMENTS SOLD IN EACH QUARTER THERE-AFTER. 15-03-2021  View

;
S.No.Cash InflowAmount
(In Lakhs)
1Opening Balance0
2Amount collected from allottees against booked plots and/or apartments413
3Amount availed from the bank/financial institutions0
4Amount contributed by the promoters/his associates0
5Any other receipt0
Total413



S.No.Cash OutflowAmount
(In Lakhs)
1Expenditure on construction of apartments83.94
2Expenditure on infrastructure & other structure0
3Other costs including EDC, taxes, etc665.5
Total749.44
Balance0



S.No.Information relating to Escrow AccountAmount
(In Lakhs)
1Opening balance at the beginning of the quarter180.29
2Amount deposited in Escrow Account289.1
3Amount withdrawn during the quarter0
4Balance at the end of the quarter310
Total Plots in the colony242
Plots sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1PLOTS0



Total Apartments in the colony0
Apartments sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



Total Garages in the colony0
Garages sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



S.No.Expenditure on Infrastructure made in the QuarterAmount
(In Lakhs)
1Infrastructure140
2Apartments6
3EDC, IDC, etc0
4Others Expenditure0



S.No.Expenditure on Taxes,Levies,EDC etc in the QuarterAmount
(In Lakhs)
1Actual paid as on date6.73
2EDC due as on date0
Sr. No.Document DescriptionDate of Upload Document View
1 A SEPARATE CERTIFICATE BY A CHARTERED ACCOUNTANT CERTIFYING THE TOTAL CUMULATIVE COST INCURRED ON CONSTRUCTION OF THE PROJECT UPTO END OF LAST QUARTER; THE PERCENTAGE OF REMAINING WORK IN TERMS OF COST, AND THE ESTIMATED BALANCE COST TO BE INCURRED FOR COMPLETION OF THE PROJECT. 03-05-2021  View
2 CERTIFICATE OF CHARTERED ACCOUNTANT OF THE PROJECT TO SHOW TOTAL AMOUNT OF MONEY RECEIVED FROM ALLOTTEES AND OTHER SOURCES; MONEY DEPOSITED IN THE ESCROW ACCOUNT; THE MONEY WITHDRAWN FROM THE ESCROW ACCOUNT; AMOUNT OF FUNDS INVESTED ON THE CONSTRUCTION WORK OF THE PROJECT INCLUDING PURCHASE OF MATERIALS. THE CERTIFICATE SHALL ALSO CONTAIN INFORMATION RELATING TO THE QUANTUM OF MONEY WITHDRAWN BY THE PROMOTERS FOR THE PURPOSES OTHER THAN FOR THE PROJECT 19-06-2021  View
3 CERTIFICATE OF THE REGISTERED ARCHITECT OF THE PROJECT CERTIFYING THE PERCENTAGE OF THE CONSTRUCTION WORK UPTO DATE; THE PERCENTAGE OF CONSTRUCTION WORK UNDERTAKEN DURING THE PREVIOUS QUARTER; AND THE PERCENTAGE OF WORK REMAINING. 19-06-2021  View
4 SELF CERTIFICATE OF THE PROMOTER TO SHOW THE NUMBER OF PLOTS/APARTMENTS SOLD UPTO THE DATE OF REGISTRATION AND THE PLOTS/APARTMENTS SOLD IN EACH QUARTER THERE-AFTER. 19-06-2021  View
5 A CERTIFICATE OF THE REGISTERED ENGINEER CERTIFYING PERCENTAGE OF INFRASTRUCTURE WORK CARRIED OUT. THE INFRASTRUCTURE WORK INCLUDES ROADS, SEWERAGE SYSTEM, STORM WATER DRAINAGE SYSTEM, WATER SUPPLY, AND ELECTRICITY SUPPLY. 22-06-2021  View

;
S.No.Cash InflowAmount
(In Lakhs)
1Opening Balance0
2Amount collected from allottees against booked plots and/or apartments413
3Amount availed from the bank/financial institutions0
4Amount contributed by the promoters/his associates0
5Any other receipt0
Total413



S.No.Cash OutflowAmount
(In Lakhs)
1Expenditure on construction of apartments249.5
2Expenditure on infrastructure & other structure83.94
3Other costs including EDC, taxes, etc0
Total416
Balance749.44



S.No.Information relating to Escrow AccountAmount
(In Lakhs)
1Opening balance at the beginning of the quarter180.29
2Amount deposited in Escrow Account289.1
3Amount withdrawn during the quarter159.39
4Balance at the end of the quarter310
Total Plots in the colony241
Plots sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1PLOTS0



Total Apartments in the colony0
Apartments sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



Total Garages in the colony0
Garages sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



S.No.Expenditure on Infrastructure made in the QuarterAmount
(In Lakhs)
1Infrastructure140
2Apartments6
3EDC, IDC, etc0
4Others Expenditure0



S.No.Expenditure on Taxes,Levies,EDC etc in the QuarterAmount
(In Lakhs)
1Actual paid as on date6.73
2EDC due as on date1996.75
Sr. No.Document DescriptionDate of Upload Document View
1 CERTIFICATE OF CHARTERED ACCOUNTANT OF THE PROJECT TO SHOW TOTAL AMOUNT OF MONEY RECEIVED FROM ALLOTTEES AND OTHER SOURCES; MONEY DEPOSITED IN THE ESCROW ACCOUNT; THE MONEY WITHDRAWN FROM THE ESCROW ACCOUNT; AMOUNT OF FUNDS INVESTED ON THE CONSTRUCTION WORK OF THE PROJECT INCLUDING PURCHASE OF MATERIALS. THE CERTIFICATE SHALL ALSO CONTAIN INFORMATION RELATING TO THE QUANTUM OF MONEY WITHDRAWN BY THE PROMOTERS FOR THE PURPOSES OTHER THAN FOR THE PROJECT 21-07-2021  View
2 CERTIFICATE OF THE REGISTERED ARCHITECT OF THE PROJECT CERTIFYING THE PERCENTAGE OF THE CONSTRUCTION WORK UPTO DATE; THE PERCENTAGE OF CONSTRUCTION WORK UNDERTAKEN DURING THE PREVIOUS QUARTER; AND THE PERCENTAGE OF WORK REMAINING. 21-07-2021  View
3 A SEPARATE CERTIFICATE BY A CHARTERED ACCOUNTANT CERTIFYING THE TOTAL CUMULATIVE COST INCURRED ON CONSTRUCTION OF THE PROJECT UPTO END OF LAST QUARTER; THE PERCENTAGE OF REMAINING WORK IN TERMS OF COST, AND THE ESTIMATED BALANCE COST TO BE INCURRED FOR COMPLETION OF THE PROJECT. 21-07-2021  View
4 A CERTIFICATE OF THE REGISTERED ENGINEER CERTIFYING PERCENTAGE OF INFRASTRUCTURE WORK CARRIED OUT. THE INFRASTRUCTURE WORK INCLUDES ROADS, SEWERAGE SYSTEM, STORM WATER DRAINAGE SYSTEM, WATER SUPPLY, AND ELECTRICITY SUPPLY. 21-07-2021  View
5 SELF CERTIFICATE OF THE PROMOTER TO SHOW THE NUMBER OF PLOTS/APARTMENTS SOLD UPTO THE DATE OF REGISTRATION AND THE PLOTS/APARTMENTS SOLD IN EACH QUARTER THERE-AFTER. 21-07-2021  View

;
S.No.Cash InflowAmount
(In Lakhs)
1Opening Balance0
2Amount collected from allottees against booked plots and/or apartments239.54
3Amount availed from the bank/financial institutions0
4Amount contributed by the promoters/his associates0
5Any other receipt0
Total239.54



S.No.Cash OutflowAmount
(In Lakhs)
1Expenditure on construction of apartments0
2Expenditure on infrastructure & other structure108.08
3Other costs including EDC, taxes, etc131.46
Total239.54
Balance0



S.No.Information relating to Escrow AccountAmount
(In Lakhs)
1Opening balance at the beginning of the quarter0
2Amount deposited in Escrow Account239.54
3Amount withdrawn during the quarter239.54
4Balance at the end of the quarter0
Total Plots in the colony242
Plots sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1PLOTS0



Total Apartments in the colony0
Apartments sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



Total Garages in the colony0
Garages sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



S.No.Expenditure on Infrastructure made in the QuarterAmount
(In Lakhs)
1Infrastructure386
2Apartments6
3EDC, IDC, etc131.46
4Others Expenditure0



S.No.Expenditure on Taxes,Levies,EDC etc in the QuarterAmount
(In Lakhs)
1Actual paid as on date773.20
2EDC due as on date125.72
Sr. No.Document DescriptionDate of Upload Document View
1 SELF CERTIFICATE OF THE PROMOTER TO SHOW THE NUMBER OF PLOTS/APARTMENTS SOLD UPTO THE DATE OF REGISTRATION AND THE PLOTS/APARTMENTS SOLD IN EACH QUARTER THERE-AFTER. 02-08-2021  View
2 CERTIFICATE OF CHARTERED ACCOUNTANT OF THE PROJECT TO SHOW TOTAL AMOUNT OF MONEY RECEIVED FROM ALLOTTEES AND OTHER SOURCES; MONEY DEPOSITED IN THE ESCROW ACCOUNT; THE MONEY WITHDRAWN FROM THE ESCROW ACCOUNT; AMOUNT OF FUNDS INVESTED ON THE CONSTRUCTION WORK OF THE PROJECT INCLUDING PURCHASE OF MATERIALS. THE CERTIFICATE SHALL ALSO CONTAIN INFORMATION RELATING TO THE QUANTUM OF MONEY WITHDRAWN BY THE PROMOTERS FOR THE PURPOSES OTHER THAN FOR THE PROJECT 02-08-2021  View
3 A SEPARATE CERTIFICATE BY A CHARTERED ACCOUNTANT CERTIFYING THE TOTAL CUMULATIVE COST INCURRED ON CONSTRUCTION OF THE PROJECT UPTO END OF LAST QUARTER; THE PERCENTAGE OF REMAINING WORK IN TERMS OF COST, AND THE ESTIMATED BALANCE COST TO BE INCURRED FOR COMPLETION OF THE PROJECT. 02-08-2021  View
4 CERTIFICATE OF THE REGISTERED ARCHITECT OF THE PROJECT CERTIFYING THE PERCENTAGE OF THE CONSTRUCTION WORK UPTO DATE; THE PERCENTAGE OF CONSTRUCTION WORK UNDERTAKEN DURING THE PREVIOUS QUARTER; AND THE PERCENTAGE OF WORK REMAINING. 02-08-2021  View
5 A CERTIFICATE OF THE REGISTERED ENGINEER CERTIFYING PERCENTAGE OF INFRASTRUCTURE WORK CARRIED OUT. THE INFRASTRUCTURE WORK INCLUDES ROADS, SEWERAGE SYSTEM, STORM WATER DRAINAGE SYSTEM, WATER SUPPLY, AND ELECTRICITY SUPPLY. 02-08-2021  View

;
S.No.Cash InflowAmount
(In Lakhs)
1Opening Balance104.20
2Amount collected from allottees against booked plots and/or apartments141.37
3Amount availed from the bank/financial institutions0
4Amount contributed by the promoters/his associates0
5Any other receipt0
Total245.57



S.No.Cash OutflowAmount
(In Lakhs)
1Expenditure on construction of apartments25
2Expenditure on infrastructure & other structure48.07
3Other costs including EDC, taxes, etc154
Total227.07
Balance0



S.No.Information relating to Escrow AccountAmount
(In Lakhs)
1Opening balance at the beginning of the quarter104.20
2Amount deposited in Escrow Account141.37
3Amount withdrawn during the quarter227.07
4Balance at the end of the quarter18.50
Total Plots in the colony242
Plots sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1AFFORDABLE PLOTS0



Total Apartments in the colony0
Apartments sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



Total Garages in the colony0
Garages sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



S.No.Expenditure on Infrastructure made in the QuarterAmount
(In Lakhs)
1Infrastructure434
2Apartments6
3EDC, IDC, etc0
4Others Expenditure0



S.No.Expenditure on Taxes,Levies,EDC etc in the QuarterAmount
(In Lakhs)
1Actual paid as on date773.20
2EDC due as on date125.72
Sr. No.Document DescriptionDate of Upload Document View
1 A SEPARATE CERTIFICATE BY A CHARTERED ACCOUNTANT CERTIFYING THE TOTAL CUMULATIVE COST INCURRED ON CONSTRUCTION OF THE PROJECT UPTO END OF LAST QUARTER; THE PERCENTAGE OF REMAINING WORK IN TERMS OF COST, AND THE ESTIMATED BALANCE COST TO BE INCURRED FOR COMPLETION OF THE PROJECT. 29-10-2021  View
2 A CERTIFICATE OF THE REGISTERED ENGINEER CERTIFYING PERCENTAGE OF INFRASTRUCTURE WORK CARRIED OUT. THE INFRASTRUCTURE WORK INCLUDES ROADS, SEWERAGE SYSTEM, STORM WATER DRAINAGE SYSTEM, WATER SUPPLY, AND ELECTRICITY SUPPLY. 29-10-2021  View
3 CERTIFICATE OF CHARTERED ACCOUNTANT OF THE PROJECT TO SHOW TOTAL AMOUNT OF MONEY RECEIVED FROM ALLOTTEES AND OTHER SOURCES; MONEY DEPOSITED IN THE ESCROW ACCOUNT; THE MONEY WITHDRAWN FROM THE ESCROW ACCOUNT; AMOUNT OF FUNDS INVESTED ON THE CONSTRUCTION WORK OF THE PROJECT INCLUDING PURCHASE OF MATERIALS. THE CERTIFICATE SHALL ALSO CONTAIN INFORMATION RELATING TO THE QUANTUM OF MONEY WITHDRAWN BY THE PROMOTERS FOR THE PURPOSES OTHER THAN FOR THE PROJECT 29-10-2021  View
4 CERTIFICATE OF THE REGISTERED ARCHITECT OF THE PROJECT CERTIFYING THE PERCENTAGE OF THE CONSTRUCTION WORK UPTO DATE; THE PERCENTAGE OF CONSTRUCTION WORK UNDERTAKEN DURING THE PREVIOUS QUARTER; AND THE PERCENTAGE OF WORK REMAINING. 29-10-2021  View
5 SELF CERTIFICATE OF THE PROMOTER TO SHOW THE NUMBER OF PLOTS/APARTMENTS SOLD UPTO THE DATE OF REGISTRATION AND THE PLOTS/APARTMENTS SOLD IN EACH QUARTER THERE-AFTER. 29-10-2021  View

;
S.No.Cash InflowAmount
(In Lakhs)
1Opening Balance104.20
2Amount collected from allottees against booked plots and/or apartments141.37
3Amount availed from the bank/financial institutions0
4Amount contributed by the promoters/his associates0
5Any other receipt0
Total245.57



S.No.Cash OutflowAmount
(In Lakhs)
1Expenditure on construction of apartments25
2Expenditure on infrastructure & other structure48.07
3Other costs including EDC, taxes, etc0
Total154.00
Balance227.07



S.No.Information relating to Escrow AccountAmount
(In Lakhs)
1Opening balance at the beginning of the quarter104.20
2Amount deposited in Escrow Account141.37
3Amount withdrawn during the quarter227.07
4Balance at the end of the quarter18.50
Total Plots in the colony242
Plots sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1AFFORDABLE0



Total Apartments in the colony0
Apartments sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



Total Garages in the colony0
Garages sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



S.No.Expenditure on Infrastructure made in the QuarterAmount
(In Lakhs)
1Infrastructure434
2Apartments6
3EDC, IDC, etc0
4Others Expenditure0



S.No.Expenditure on Taxes,Levies,EDC etc in the QuarterAmount
(In Lakhs)
1Actual paid as on date773.20
2EDC due as on date125.72
Sr. No.Document DescriptionDate of Upload Document View
1 CERTIFICATE OF CHARTERED ACCOUNTANT OF THE PROJECT TO SHOW TOTAL AMOUNT OF MONEY RECEIVED FROM ALLOTTEES AND OTHER SOURCES; MONEY DEPOSITED IN THE ESCROW ACCOUNT; THE MONEY WITHDRAWN FROM THE ESCROW ACCOUNT; AMOUNT OF FUNDS INVESTED ON THE CONSTRUCTION WORK OF THE PROJECT INCLUDING PURCHASE OF MATERIALS. THE CERTIFICATE SHALL ALSO CONTAIN INFORMATION RELATING TO THE QUANTUM OF MONEY WITHDRAWN BY THE PROMOTERS FOR THE PURPOSES OTHER THAN FOR THE PROJECT 08-11-2021  View
2 A SEPARATE CERTIFICATE BY A CHARTERED ACCOUNTANT CERTIFYING THE TOTAL CUMULATIVE COST INCURRED ON CONSTRUCTION OF THE PROJECT UPTO END OF LAST QUARTER; THE PERCENTAGE OF REMAINING WORK IN TERMS OF COST, AND THE ESTIMATED BALANCE COST TO BE INCURRED FOR COMPLETION OF THE PROJECT. 08-11-2021  View
3 CERTIFICATE OF THE REGISTERED ARCHITECT OF THE PROJECT CERTIFYING THE PERCENTAGE OF THE CONSTRUCTION WORK UPTO DATE; THE PERCENTAGE OF CONSTRUCTION WORK UNDERTAKEN DURING THE PREVIOUS QUARTER; AND THE PERCENTAGE OF WORK REMAINING. 08-11-2021  View
4 A CERTIFICATE OF THE REGISTERED ENGINEER CERTIFYING PERCENTAGE OF INFRASTRUCTURE WORK CARRIED OUT. THE INFRASTRUCTURE WORK INCLUDES ROADS, SEWERAGE SYSTEM, STORM WATER DRAINAGE SYSTEM, WATER SUPPLY, AND ELECTRICITY SUPPLY. 08-11-2021  View

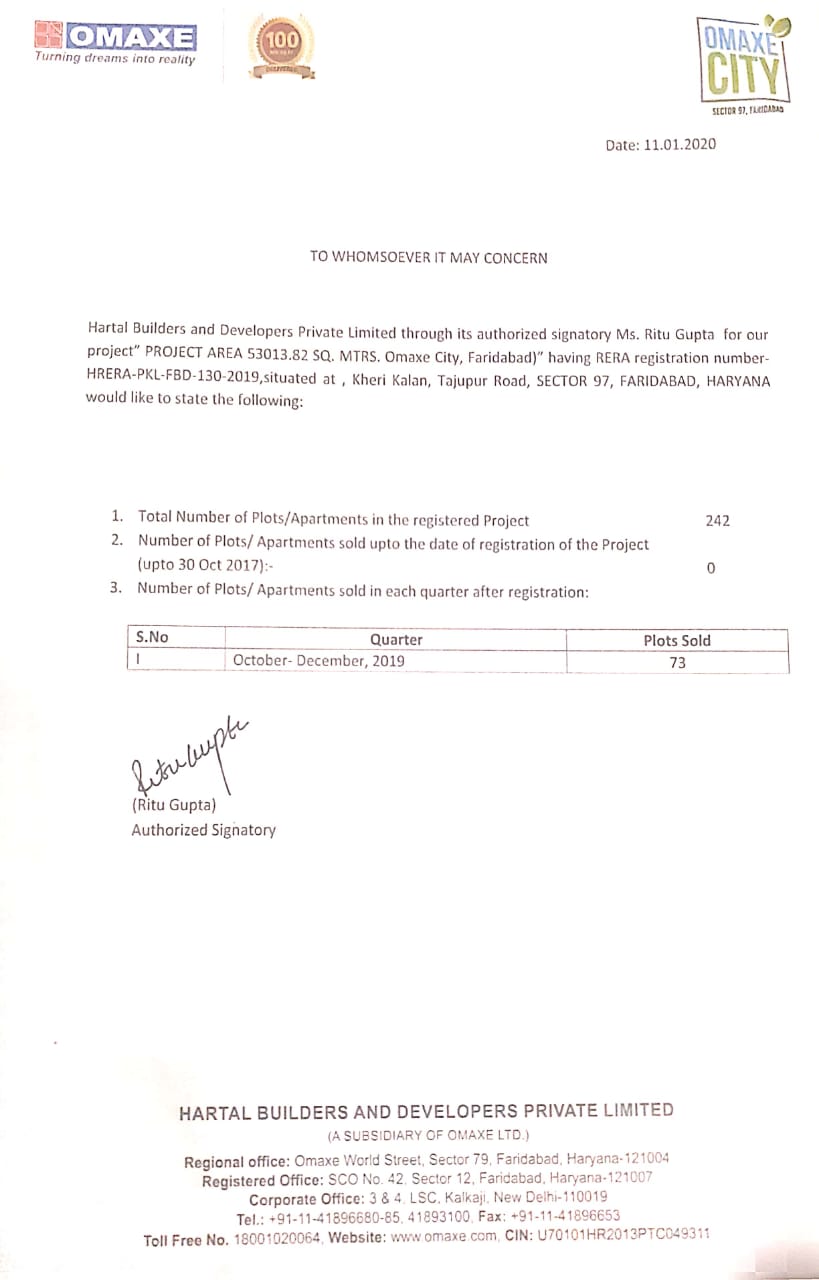

5 SELF CERTIFICATE OF THE PROMOTER TO SHOW THE NUMBER OF PLOTS/APARTMENTS SOLD UPTO THE DATE OF REGISTRATION AND THE PLOTS/APARTMENTS SOLD IN EACH QUARTER THERE-AFTER. 08-11-2021  View

;
S.No.Cash InflowAmount
(In Lakhs)
1Opening Balance104.20
2Amount collected from allottees against booked plots and/or apartments141.37
3Amount availed from the bank/financial institutions0
4Amount contributed by the promoters/his associates0
5Any other receipt0
Total245.57



S.No.Cash OutflowAmount
(In Lakhs)
1Expenditure on construction of apartments25
2Expenditure on infrastructure & other structure48.07
3Other costs including EDC, taxes, etc0
Total154
Balance227.07



S.No.Information relating to Escrow AccountAmount
(In Lakhs)
1Opening balance at the beginning of the quarter104.20
2Amount deposited in Escrow Account141.37
3Amount withdrawn during the quarter227.07
4Balance at the end of the quarter18.50
Total Plots in the colony242
Plots sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
1AFFORDABLE0



Total Apartments in the colony0
Apartments sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



Total Garages in the colony0
Garages sold upto the date of Registration0



S.No.Type/SizePlots Sold in the Quarter
10



S.No.Expenditure on Infrastructure made in the QuarterAmount
(In Lakhs)
1Infrastructure434
2Apartments6
3EDC, IDC, etc0
4Others Expenditure0



S.No.Expenditure on Taxes,Levies,EDC etc in the QuarterAmount
(In Lakhs)
1Actual paid as on date773.20
2EDC due as on date125.72
Sr. No.Document DescriptionDate of Upload Document View
1 SELF CERTIFICATE OF THE PROMOTER TO SHOW THE NUMBER OF PLOTS/APARTMENTS SOLD UPTO THE DATE OF REGISTRATION AND THE PLOTS/APARTMENTS SOLD IN EACH QUARTER THERE-AFTER. 08-11-2021  View
2 CERTIFICATE OF CHARTERED ACCOUNTANT OF THE PROJECT TO SHOW TOTAL AMOUNT OF MONEY RECEIVED FROM ALLOTTEES AND OTHER SOURCES; MONEY DEPOSITED IN THE ESCROW ACCOUNT; THE MONEY WITHDRAWN FROM THE ESCROW ACCOUNT; AMOUNT OF FUNDS INVESTED ON THE CONSTRUCTION WORK OF THE PROJECT INCLUDING PURCHASE OF MATERIALS. THE CERTIFICATE SHALL ALSO CONTAIN INFORMATION RELATING TO THE QUANTUM OF MONEY WITHDRAWN BY THE PROMOTERS FOR THE PURPOSES OTHER THAN FOR THE PROJECT 08-11-2021  View
3 A SEPARATE CERTIFICATE BY A CHARTERED ACCOUNTANT CERTIFYING THE TOTAL CUMULATIVE COST INCURRED ON CONSTRUCTION OF THE PROJECT UPTO END OF LAST QUARTER; THE PERCENTAGE OF REMAINING WORK IN TERMS OF COST, AND THE ESTIMATED BALANCE COST TO BE INCURRED FOR COMPLETION OF THE PROJECT. 08-11-2021  View
4 CERTIFICATE OF THE REGISTERED ARCHITECT OF THE PROJECT CERTIFYING THE PERCENTAGE OF THE CONSTRUCTION WORK UPTO DATE; THE PERCENTAGE OF CONSTRUCTION WORK UNDERTAKEN DURING THE PREVIOUS QUARTER; AND THE PERCENTAGE OF WORK REMAINING. 08-11-2021  View
5 A CERTIFICATE OF THE REGISTERED ENGINEER CERTIFYING PERCENTAGE OF INFRASTRUCTURE WORK CARRIED OUT. THE INFRASTRUCTURE WORK INCLUDES ROADS, SEWERAGE SYSTEM, STORM WATER DRAINAGE SYSTEM, WATER SUPPLY, AND ELECTRICITY SUPPLY. 08-11-2021  View
